Villa Park Recreation Center Construction

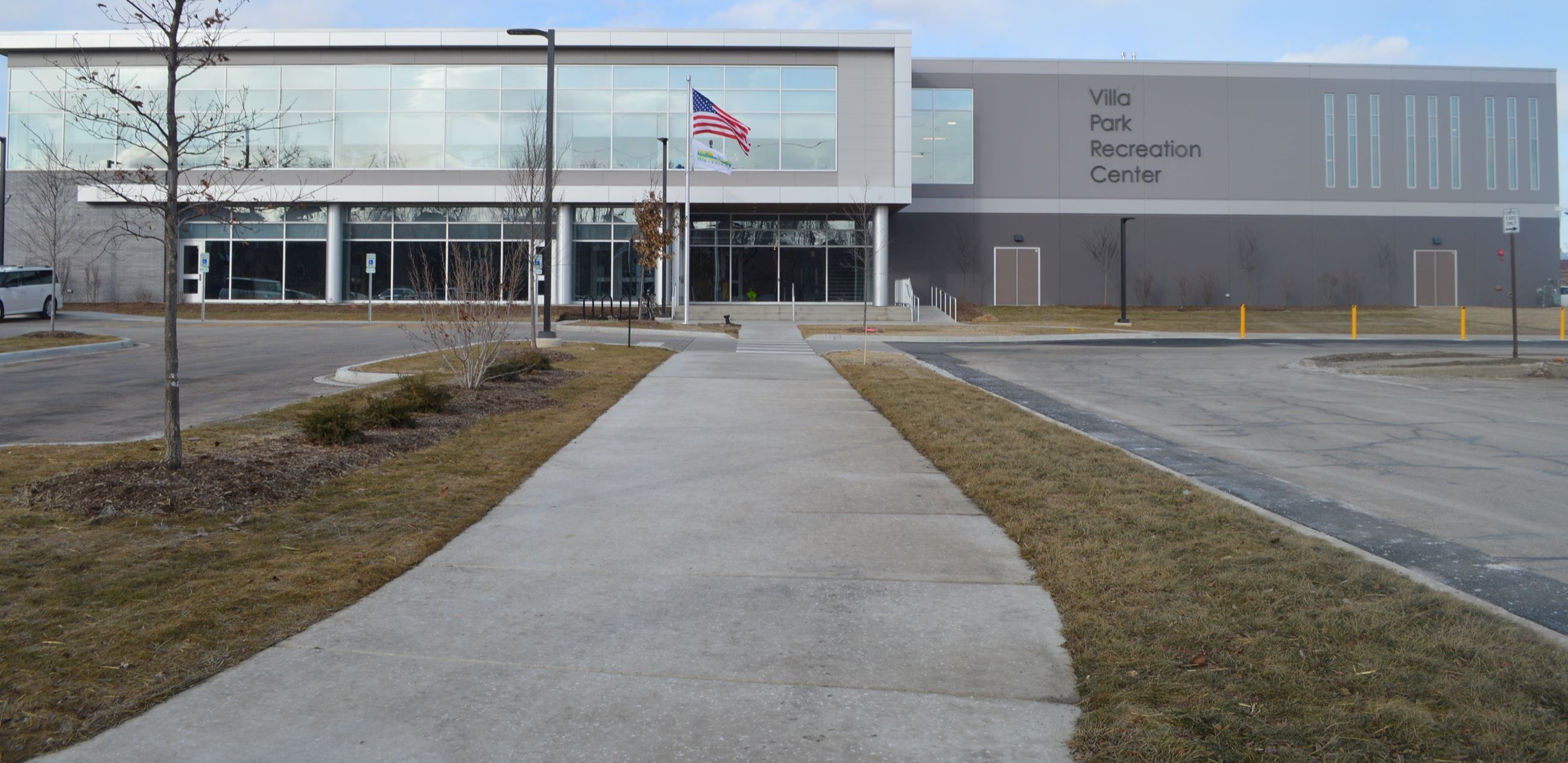

We're thrilled the VPRC is now open as of January 3, 2025 with our ribbon-cutting ceremony taking place on January 13. The new recreation center features many modern amenities, including a full gymnasium, an elevated track, a stretching area, a fully equipped fitness center, two (2) classrooms, two (2) multipurpose rooms, an educational commercial kitchen, locker rooms with showers and a roof-top terrace! We have increased our programs to utilize the new spaces! Please visit our website for more information. We can't wait to see you there!

DSC_0803

On the exterior, the last of the glass has been installed, the column wraps are installed, the building address is installed, and the roof terrace pavers have been installed. Generally, the exterior is complete, with the main entrance auto operator, fire suppression alarm bell, and terrace roof railing being all that remains as we approach the end of the project. On the interior, the second floor the running track and stretching area rubber flooring has been installed, lockers throughout the second floor installed, ceiling fans in the Dance Studio and Fitness center installed, the AV equipment (monitors and speakers) installed, the security cameras have been mounted, and the room signage has been installed. Generally, all that remains is the flooring for the Fitness Center. On the first floor, the gym floor markings have been completed, all the gym equipment has been installed, the multi-purpose floor has been completed, all folding partitions have been installed, the window shades installed, AV equipment installed, security cameras mounted, countertops and reception desk have been installed, carpet in the offices installed, and the elevator has been certified.  Overall, the interior is wrapping up with loose ends, various inspections, and testing, as the project makes way for final inspections, punchlisting activities, and Owner FFE deliveries. The project is scheduled to be completed in December 2024. Currently, the project has experienced 34 days of lost work due to the weather.

Budget

The current approved Project budget including all construction and Owner costs is $20.181 Million.  The current estimate of the construction cost is $18.1 Million.

Apprenticeship Participation

To date, apprenticeship participation is on track through October.

Safety

Through November 2024 there have been no injuries and/or lost days due to accidents.

Submittals

The submittal process is complete.

RFIs

To date there have been 164 RFIs issued, and 0 are currently open. There are no critical/priority RFIs at this time.

Project Achievements/Completed Milestones

  1. 100% of the ACT tile has been installed.
  2. 100% of the exterior window system has been installed.
  3. 100% of the ceramic tile in the locker rooms has been installed
  4. 100% of the exterior FRP doors have been installed.
  5. 100% of the elevator has been installed/certified.
  6. 100% of the terrazzo floor install is complete (polishing all that remains)
  7. 100% of the plumbing fixtures have been installed.
  8. 100% of wall protection has been installed.
  9. 100% of the interior window systems have been installed.
  10. 100% of the 1st flr & exterior Bldg lights have been installed.
  11. 100% of the low voltage systems has been installed.
  12. 100% of the ceiling clouds have been installed
  13. 100% of exterior lighting has been installed.
  14. 100% of the gym wood floors have been installed
  15. 100% of the multi-purpose rm floors have been installed.
  16. 100% of the LVT floors have been installed.
  17. 100% of the gym backstop install is complete
  18. 100% Pre-testing of FA Systems
  19. 100% Test & Balance of MEP systems

 Upcoming Milestones

  1. Install of Fitness Center Flooring System – Dec 2024
  2. Install of Permanent Cores in Door Locks – Dec 2024
  3. Install of Ballfield lighting controls – Dec 2024
  4. Install of Roof Terrace Railing – Dec 2024
  5. Final Cleaning of Facility – Dec 2024
  6. Installation of Owner Security Systems – Dec 2024
  7. Installation of Owner IT Equipment – Dec 2024
  8. Installation of Owner Fitness Equipment – Dec 2024
  9. Installation of Owner Furnishings – Dec 2024
  10. Commissioning of Plumbing Systems – Dec 2024
  11. Commissioning of HVAC Systems – Dec 2024
  12. Commissioning of Lighitng Controls – Dec 2024
  13. Final DuPage County Health Inspection – Dec 2024
  14. Final Testing of FA System – Dec 2024
  15. Final Building Inspections – Dec 2024
  16. Submission of Certificate of Occupancy (COO) – Dec 2024

Approximately 44,019 man hours have been worked to date, with 4,608 man hours in the month of October.

  1. 1 DSC_0593
  2. 2 DSC_0592
  3. 3 DSC_0591
  4. 4 DSC_0587
  5. 5 DSC_0636
  6. 6 DSC_0625
  7. 7 DSC_0617
  8. 8 DSC_0613
  9. 9 DSC_0610
  10. 10 DSC_0609
  11. 11 DSC_0606
  12. 12 DSC_0604
  13. 13 DSC_0597
  14. 14 DSC_0596
  15. 15 DSC_0595
  16. 16 DSC_0594
  17. 17 DSC_0379
  18. 18 Picture1
  19. 19 Picture2
  20. 20 Picture3
  21. 21 Picture4
  22. 22 Picture5
  23. 23 Picture6
  24. 24 Picture7

On the exterior, facility siding has been completed, landscaping has wrapped up, permeable brick paver install of the East lot is complete, site lighting has been installed, fence at the retaining wall has been completed, and the South parking permeable paver installation has begun. On the interior, 2nd light fixtures installed and powered up, drinking fountains have been installed, wall protection system has been installed, wood floors in Dance Studio have been layed out, bathroom accessories and plumbing accessories have been installed, and LVT and carpet install has begun. On the 1st floor, light fixture has been installed, terrazzo flooring in the lobby has been installed, interior alum framing has been installed, all kitchen equipment has been installed and utilities connected, toilet partition installation is completed, plumbing trimout is completed, toilet accessories have been installed, and electric heating units have been installed.  The wood floor in the gym is installed, and the sanding process has begun, the wood floor in the multi-purpose room is being laid, and terrazzo stair treads are being installed. The project is scheduled to be completed in December 2024.  Currently the project has experienced 34 days of lost work due to the weather.

Budget

The current approved Project budget including all construction and Owner costs is $20.181 Million.  The current estimate of the construction cost is $18.1 Million.

Apprenticeship Participation

To date apprenticeship participation is on track through the month of October.  See attached report for reference.

Safety

Through Oct 2024 there have been no injuries and/or lost days due to accidents.

Submittals

The submittal process complete with the exception of a couple of new items that have arisen in the construction process for informational purposes.

RFIs

To date there have been 159 RFIs issued, 0 are currently open. There are no critical/priority RFIs at this time.

Project Achievements/Completed Milestones

  1. 100% of the 2nd flr light fixtures have been installed.
  2. 100% of the curb/gutter and walks have been installed.
  3. 100% of the FRP wall panels in Kitchen have been installed.
  4. 100% of the Food Service Equipment has been installed.
  5. 100% of RTUs have been started (heating & cooling)
  6. 100% of the ACT grid has been installed.
  7. 100% of the electric ceiling mounted heaters have been installed
  8. 100% of epoxy floor system in kitchen has been installed
  9. 99% of the exterior window system has been installed.
  10. 99% of the ceramic tile in the locker rooms has been installed.
  11. 95% of the exterior FRP doors have been installed (awaiting glass).
  12. 95% of the elevator has been installed.
  13. 90% of the terrazzo floor install is complete (polishing all that remains)
  14. 90% of the plumbing fixtures have been installed.
  15. 80% of wall protection has been installed.
  16. 75% of the interior window systems have been installed.
  17. 75% of the 1st flr & exterior Bldg lights have been installed.
  18. 75% of the low voltage systems has been installed.
  19. 60% of the ceiling clouds have been installed
  20. 60% of exterior lighting has been installed.
  21. 75% of the gym wood floors have been installed
  22. 30% of the muli-purpose rm floors have been installed.
  23. 30% of the LVT floors have been installed.
  24. 15% of the gym backstop install is complete

Upcoming Milestones

  1. Complete install of 1st flr light fixtures – Nov 2024
  2. Complete install of elevator system – Nov 2024
  3. Complete install of Gym Backstops – Nov 2024
  4. Complete install of interior alum glazing systems – Nov 2024
  5. Complete install of brick paver system – Nov 2024
  6. Complete install of Gym Floor System – Nov 2024
  7. Complete install of Multi-Purpose Floor System – Nov 2024
  8. Complete install of Dance Studio Floor System – Nov 2024
  9. Complete install of rubber floor system – Nov 2024
  10. Complete install of LVT/Carpet floor system – Nov 2024
  11. Complete install of running track floor – Nov 2024
  12. Complete install of millwork – Nov 2024
  13. Complete install of MEPFP trim – Nov 2024
  14. Complete install of asphalt patching – Nov 2024
  15. Complete install of fencing – Nov 2024
  16. Complete install of folding partition system – Nov 2024
  17. Complete install of gym equipment – Nov 2024
  18. Complete install of Dr & HDW – Nov 2024
  19. Complete install of Lighting Controls – Nov 2024
  20. Complete install of ACT tile – Nov 2024
  21. Complete install of room signage – Nov 2024
  22. Testing of FA Sytems – Nov 2024
  23. Test & Balance of MEP systems – Nov 2024

 Approximately 38,275 man hours have been worked to date, with 5,936 man hours in the month of October

Priority Action List

  • Complete install of all flooring
  • Complete install of millwork
  • Complete install of doors & HDW
  • Complete Test & Balancing activities
  • Complete Fire Alarm Testing
  • Prelim Testing of Elevator
  • Prelim Testing of Access Controls
  • Prelim Testing of Lighting Controls
  • Temp Occupancy Inspections

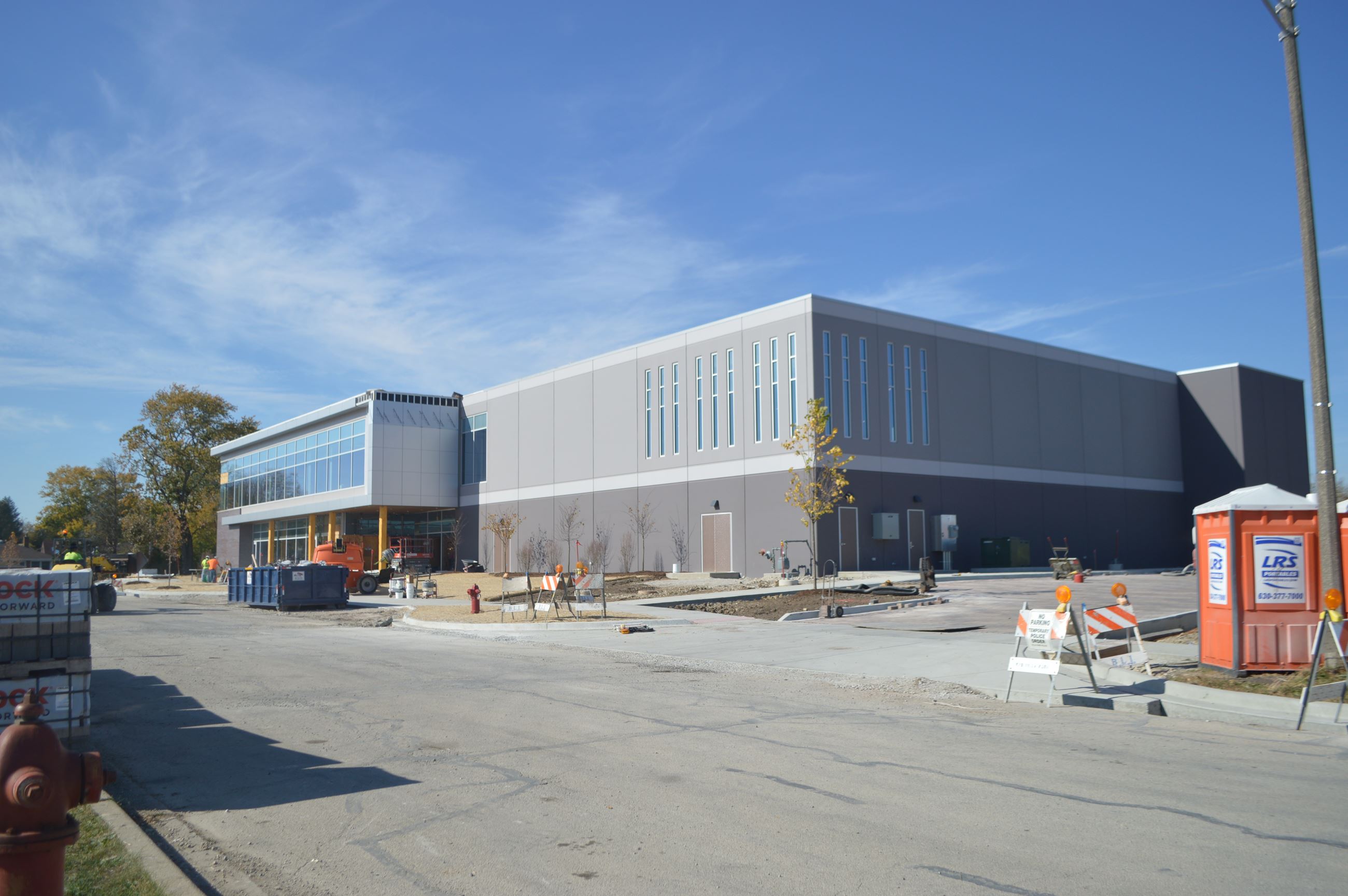

  1. 1 DSC_0175
  2. 2 DSC_0178
  3. 3 DSC_0179
  4. 4 Picture13
  5. 5 DSC_0181
  6. 6 DSC_0182
  7. 7 DSC_0184
  8. 8 DSC_0189
  9. 9 DSC_0190
  10. 10 DSC_0191
  11. 11 Picture14
  12. 12 DSC_0193
  13. 13 DSC_0201
  14. 14 DSC_0202
  15. 15 DSC_0208
  16. 16 Picture1
  17. 17 Picture2
  18. 18 Picture4
  19. 19 Picture5
  20. 20 Picture7
  21. 21 Picture8
  22. 22 Picture9
  23. 23 Picture12

The construction fence has been removed on the exterior.  Site work has begun with light pole base installation, exterior door stoops installed, South lot curb and gutters, sidewalks installed, and front entrance stairs/ramp completed.  The install for the new metal panel systems for the soffits has begun. Site grading along the West and North elevations has begun. On the interior, drywall activities are wrapping up, The divider curtains in the gym have been installed, final coat of paint on the 2nd floor has been completed, the ceiling grid in various areas has been installed, light fixtures are being installed, Grand Stair has been installed, the fire alarm system is being final roughed in and trimmed out, alum window systems are being installed, and floors are being prepared to receive flooring.  On the 1st floor Ceramic tile installation in the locker rooms is wrapping up, FRP wall paneling in the kitchen has begun, the first coat of paint is complete, for the bathrooms throughout the facility has been delivered and installation has begun.  Bathroom plumbing fixtures are being installed. The project is scheduled to be completed in December 2024. The project has experienced 34 days of lost work due to the weather.

Budget

The current approved Project budget including all construction and Owner costs is $20.181 Million.  The current estimate of the construction cost is $18.1 Million.

Apprenticeship Participation

To date, apprenticeship participation is on track through the month of September.

Safety

Through Sep 2024 there have been no injuries and/or lost days due to accidents.

Submittals

The submittal process is complete with the exception of a couple of new items that have arisen in the construction process for informational purposes.

RFIs

To date there have been 151 RFIs issued, and 1 is currently open. installation. There are no critical/priority RFIs at this time.

Project Achievements/Completed Milestones

  1. 100% of the painting the exterior pre-cast walls
  2. 100% of the ceramic tile in the bathrooms is complete
  3. 100% of the gym curtain divider install is complete
  4. 100% facility gas meter and service has been installed.
  5. 100% of the 2nd flr drywall has been installed.
  6. 100% of the water heater installation has been completed
  7. 100% of the 1st flr drywall has been installed.
  8. 100% of light pole bases have been installed.
  9. 100% of the exposed ceiling decks have been painted.
  10. 100% of the 2nd flr ceiling grid has been completed
  11. 100% of the gym light fixtures has been installed
  12. 100% of the gym overhead door system has been installed.
  13. 99% of the exterior window system has been installed.
  14. 95% of the ceramic tile in the locker rooms has been installed.
  15. 90% of the exterior FRP doors have been installed.
  16. 80% of the 2nd flr light fixtures have been installed.
  17. 75% of the curb/gutter and walks have been installed.
  18. 50% of the elevator has been installed.
  19. 40% of the low voltage systems has been installed.
  20. 30% of the plumbing fixtures have been installed.
  21. 30% of the FRP wall panels in Kitchen have been installed.
  22. 15% of the gym backstop install is complete

Upcoming Milestones

  1. Complete install of curb/gutter & walks – Oct 2024
  2. Complete install of metal soffit panel system – Oct 2024
  3. Complete install of landscaping – Oct 2024
  4. Complete install of exterior lighting – Oct 2024
  5. Complete install of fire suppression trim – Oct 2024
  6. Complete install of 1st flr light fixtures – Oct 2024
  7. Complete install of elevator system – Oct 2024
  8. Complete installation of exterior hardscape (sidewalks, curbs/gutters) – Oct 2024
  9. Complete install 1st Flr ACT system – Oct 2024
  10. Complete install of Gym Backstops – Nov 2024
  11. Complete install of Kitchen Epoxy Flr System – Oct 2024
  12. Complete install of plumbing fixtures – Oct 2024
  13. Complete install of interior alum glazing systems – Oct 2024
  14. Complete install of brick paver system – Oct 2024
  15. Begin install of rubber floor system – Oct 2024
  16. Begin install of running track floor – Oct 2024
  17. Begin install of LVT floor system – Oct 2024
  18. Begin install of Carpet floor system – Oct 2024
  19. Begin install of Terrazzo floor system – Oct 2024
  20. Begin install of Kitchen Equipment – Oct 2024
  21. Begin install of Gym Floor System – Oct 2024
  22. Begin install of Group X/Dance Floor System – Oct 2024
  23. Begin install of toilet partitions/accessories – Oct 2024
  24. Begin install of millwork – Oct 2024
  25. Begin install of MEPFP trim – Oct 2024
  26. Begin install of asphalt patching – Oct 2024
  27. Begin install of site lighting – Oct 2024
  28. Begin install of fencing – Oct 2024

Approximately 32,339 man hours have been worked to date, with 5,408 man hours in the month of September.

Priority Action List

  • Complete install of wood floors
  • Complete install of exterior glazing
  • Complete exterior site work (curb/gutter/sidewalk/brick pavers/landscaping/site lighting)
  1. 1 Picture1
  2. 2 1000001268
  3. 3 1000001274
  4. 4 Picture2
  5. 5 Picture3
  6. 6 Picture4
  7. 7 Picture5
  8. 8 Picture6
  9. 9 Picture7
  10. 10 Picture8
  11. 11 Picture9
  12. 12 Picture10
  13. 13 Picture11
  14. 14 Picture12
  15. 15 Picture13
  16. 16 Picture14

On the exterior, the window systems are nearing completion.  The new exterior wall panel system has been installed.  Metal panel systems for the soffits have been field-measured and are in fabrication. Sheet metal coping is being installed on the gym roof.  The rooftop units (RTUs) have been started.  All MEPFP rough-in inspections have been completed on the interior and drywall activities are ongoing.  The gym has been painted, and the first coat of paint is being installed on the 2nd-floor.  Ceramic tile for the bathrooms throughout the facility has been delivered and installation has begun.  The site lighting is being roughed in with light pole base installation ongoing. The project is scheduled to be completed in December 2024.  Currently, the project has experienced 34 days of lost work due to the weather.

Budget

The current approved Project budget including all construction and Owner costs is $20.181 Million.  The current estimate of the construction cost is $18.1 Million.

Apprenticeship Participation

To date, apprenticeship participation is on track through July.  See attached report for reference.

Safety

Through August 2024 there have been no injuries and/or lost days due to accidents.

Submittals

The submittal process is wrapping up.  The last of the open submittal items are in process.

RFIs

To date, there have been 141 RFIs issued, and 1 is currently open. There are no critical/priority RFIs at this time.

Project Achievements/Completed Milestones

  1. RTUs have been started
  2. Permanent Power to the facility is now available.
  3. 100% of the Gym Overhead MEPFP has been installed.
  4. 100% of the 1st-floor framing has been completed
  5. 100% of the 1st-floor Overhead MEPFP rough-ins have been installed.
  6. 100% of the 1st-floor MEPFP in-wall rough-ins have been installed.
  7. 100% of the Gym painting has been completed
  8. 98% of the painting the exterior pre-cast walls
  9. 95% of the exterior window system has been installed.
  10. 95% of the 2nd-floor drywall has been installed.
  11. 85% of the water heater installation has been completed
  12. 50% of the 1st-floor drywall has been installed.
  13. 50% of light pole bases have been installed.

Upcoming Milestones

  1. Complete installation of light pole bases – Sep 2024
  2. Complete installation of 1st-floor drywall – Sep 2024
  3. Complete installation of the Grand Stair – Sep 2024
  4. Complete prime/paint deck program space – Sep 2024
  5. Complete prime/paint program space walls/ceilings –Sep 2024
  6. Complete install ceiling grid 2nd-floor program space – Sep 2024
  7. Complete install of ceramic tile system – Sep 2024
  8. Complete install of elevator system – Sep 2024
  9. Complete installation of exterior hardscape (sidewalks, curbs/gutters) – Sep 2024
  10. Complete install ACT system – Sep 2024
  11. Complete installation of Gym Light Fixtures – Sep 2024
  12. Complete install of Gym Backstops & Curtains – Sep 2024
  13. Begin installation of FRP wall panels in Kitchen – Sep 2024
  14. Begin installation of Gym Floor System – Sep 2024
  15. Approximately 27,259 man hours have been worked to date, with 3,872 man hours in August

Critical Action List

  • Complete all overhead installs in the Gym
  • Acclimate wood floor systems
  • Installation of Gas Meter by Nicor
  • Complete installation of exterior glazing
  • Complete exterior hardscape (curb/gutter/sidewalk)

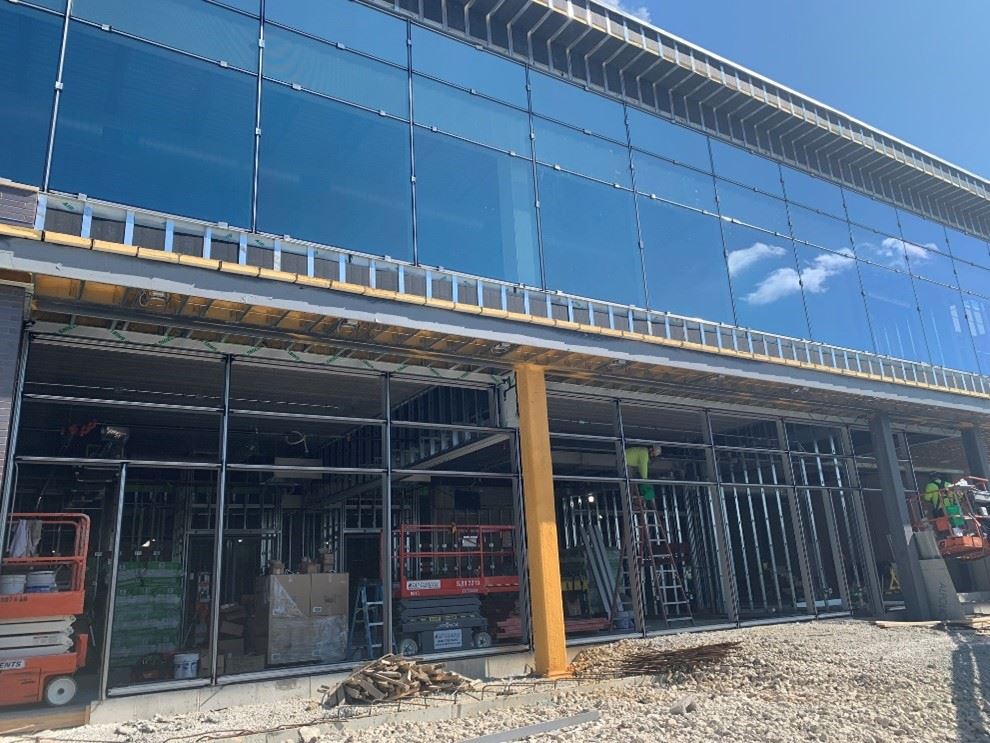

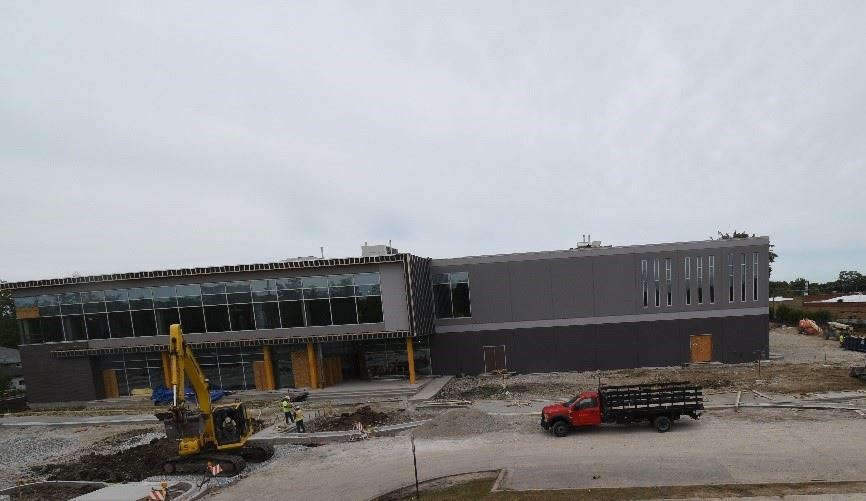

  1. 1 AugustPicture2

  2. 2 AugustPicture3
  3. 3 AugustPicture4
  4. 4 AugustPicture5
  5. 5 AugustPicture6
  6. 6 AugustPicture7
  7. 7 AugustPicture8
  8. 8 AugustPicture9
  9. 9 AugustPicture10
  10. 10 AugustPicture11
  11. 11 AugustPicture12
  12. 12 AugustPicture13
  13. 13 AugustPicture14
  14. 14 AugustPicture15

On the exterior, the window system installation is ongoing.  The new exterior wall panel system has been delivered and installation is set to begin.  The ComEd transformer has been set and the main distribution panels have been mounted.  On the 2nd floor, inspections are complete, MEPFP insulation is being installed, and drywall installation has begun.  On the 1st floor MEPFP rough-ins are wrapping up, folding partition tracks have been installed and in-wall inspections are being scheduled. The project is scheduled to be completed in December 2024.  Currently, the project has experienced 33 days of lost work due to the weather.

Budget

The current approved Project budget including all construction and Owner costs is $20.181 Million.  The current estimate of the construction cost has increased based on the change in electrical contractor to $18.1 Million.

Apprenticeship Participation

To date, apprenticeship participation is on track through June.

Safety

Through July 2024 there have been no injuries and/or lost days due to accidents.

Submittals

The submittal process is wrapping up.  Those items that remain are tied to the electrical contractor change.  It is anticipated that the balance of these items will be completed in August.

RFIs

To date, there have been 127 RFIs issued, and 3 are currently open. There are no critical/priority RFIs at this time.

Project Achievements/Completed Milestones

  1. 100% of the 2nd-floor MEPFP in-wall rough-ins have been installed.
  2. 100% of the Atrium handrail system has been installed.
  3. 95% of the Gym Overhead MEPFP has been installed.
  4. 95% of the 1st-floor framing has been completed
  5. 95% of the 1st-floor Overhead MEPFP rough-ins have been installed.
  6. 95% of the 1st-floor MEPFP in-wall rough-ins have been installed.
  7. 80% of the painting of the exterior pre-cast walls
  8. 50% of the exterior window system has been installed.
  9. 40% of the 2nd-floor drywall has been installed.
  10. Approximately 23,179 man-hours have been worked to date, with 2,944 man-hours in July.

Upcoming Milestones

  1. Complete install Alum Storefront/Curtainwall Systems – Aug 2024
  2. Complete installation of drywall throughout building – Aug 2024
  3. Complete start-up of HVAC system – Aug 2024
  4. Begin prime/paint gym deck – Aug 2024
  5. Begin prime/paint program space walls/ceilings – Aug 2024
  6. Begin installation of ceramic tile system – Aug 2024
  7. Begin installation of FRP wall panels in Kitchen – Aug 2024
  8. Being installation of elevator system – Aug 2024
  9. Begin install of grand stair system – Aug 2024
  10. Begin prep and installation of exterior hardscape (sidewalks, curbs/gutters) – Aug 2024
  11. Begin acclimation of wood floor materials – Sep 2024
  12. Begin installing ACT system – Sep 2024
  13. Begin install of Light Fixtures – Sep 2024

Critical Action List

  • Complete installation of Exterior Window Systems
  • Start-up of HVAC Systems
  • Installation of Gas Service

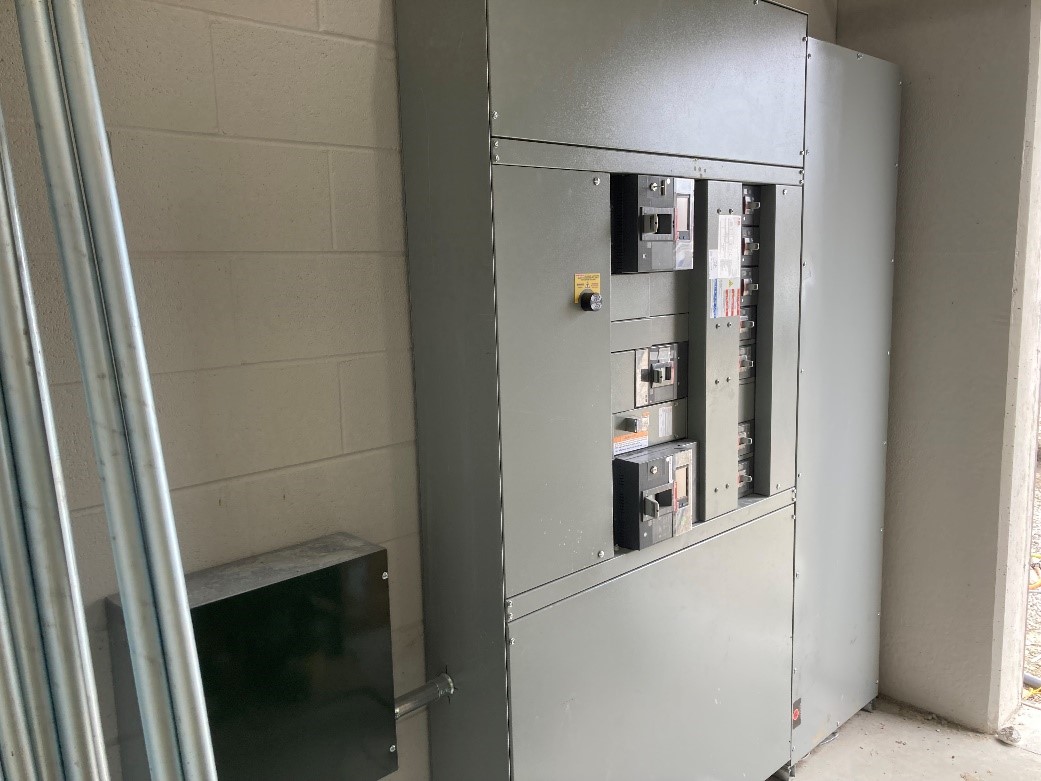

  1. 1 July24_Picture12.jpg
  2. 2 July24_Picture13.jpg
  3. 3 July24_Picture8.jpg
  4. 4 July24_Picture15.jpg
  5. 5 July24_Picture2.jpg
  6. 6 July24_Picture6.jpg
  7. 7 July24_Picture4.jpg
  8. 8 July24_Picture10.jpg
  9. 9 July24_Picture7.jpg
  10. 10 July24_Picture14.jpg
  11. 11 July24_Picture5.jpg
  12. 12 July24_Picture11.jpg
  13. 13 July24_Picture9.jpg
  14. 14 July24_Picture3.jpg
  15. 15 July24_Picture1.jpg

The current approved project budget including all construction and owner costs is $20.181 Million. The current estimate of the construction cost remains within budget at $17.9 Million.

Safety

Through June 2024 there have been no injuries and/or lost days due to accidents.

Submittals

The submittal process is wrapping up. It is anticipated that the balance of these items will be completed in the coming month.

RFIs

To date, there have been 117 RFIs issued, and 5 are currently open. There are no critical/priority RFIs at this time.

Project Achievements/Completed Milestones

  • The Gym slab-on-grade has been poured.
  • 100% of the running track concrete has been poured.
  • 100% of the 2nd-floor Overhead MEPFP rough-ins have been installed.
  • 100% program space roof system has been installed.
  • 100% of the gym roof system has been installed.
  • 100% of the exterior envelope air barrier has been installed.
  • 100% of the West/East Stairs has been installed.
  • 100% of the interior block walls have been installed.
  • 100% of the exterior brick façade has been installed.
  • 95% of the 2nd-floor MEPFP in-wall rough-ins have been installed.
  • 90% of the Gym Overhead MEPFP has been installed.
  • 80% of the 1st-floor framing has been completed
  • 80% of the 1st-floor Overhead MEPFP rough-ins have been installed.
  • 60% of the 1st-floor MEPFP in-wall rough-ins have been installed.
  • 30% of the painting of the exterior pre-cast walls.
  • 15% of the exterior window system has been installed.
  • Approximately 20,075 man hours have been worked to date, with 4,808 man hours in June.

Upcoming Milestones

  • Complete install of 1st flr framing – Jul 2024
  • Complete install of 1st flr in-wall MEPFP rough-ins – Jul 2024
  • Complete install Alum Storefront/Curtainwall Systems – Jul 2024
  • Complete painting of exterior pre-cast walls – Jul 2024
  • Complete balance of overhead MEPFP in Gym – Jul 2024
  • Coordinate/Install of ComEd Transformer – Jul 2024
  • Begin installation of drywall – Jul 2024
  • Begin installation of kitchen hood – Jul 2024
  • Begin installation of railing at atrium – Jul 2024
  • Begin prep of grand stair opening to receive new stair system – Jul 2024
  • Begin prep and installation of exterior hardscape (sidewalks, curbs/gutters) – Jul 2024

Critical Action List

  • Complete installation of Exterior Window Systems

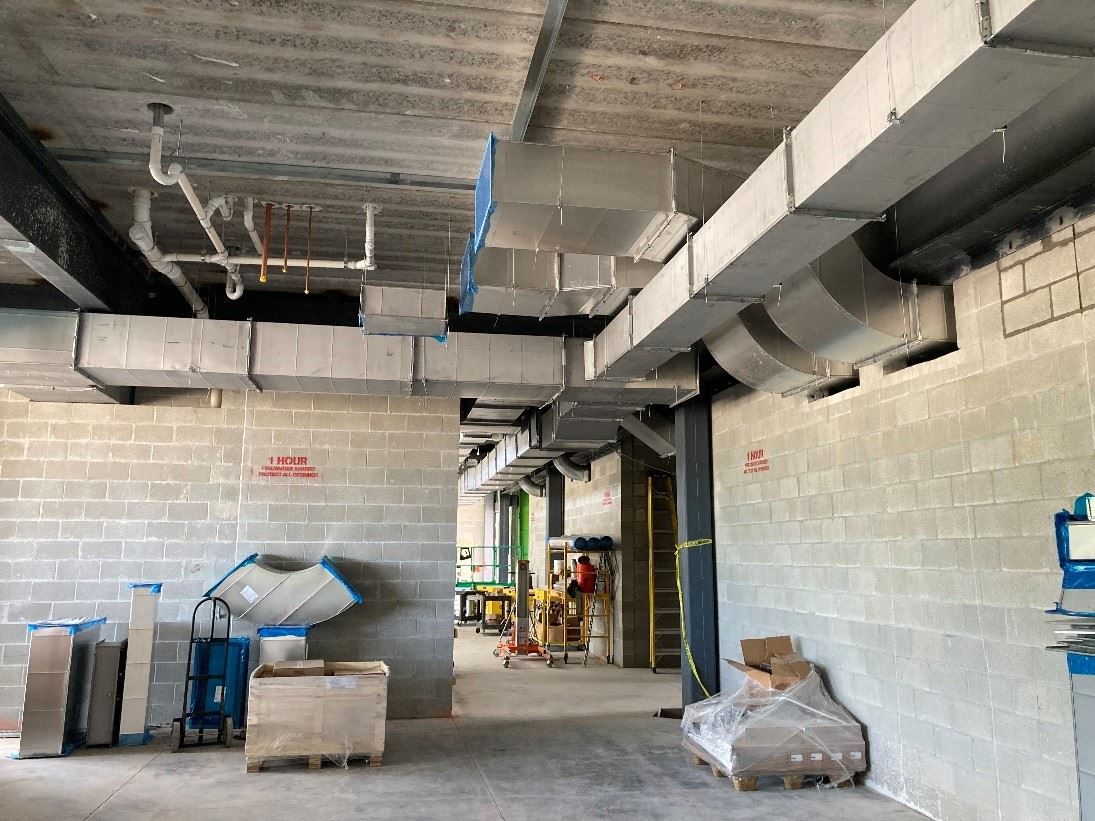

  1. 1 1st Flr Ductwork Install 11 Jun 2024
  2. 2 1st Flr Kitchen Walls Framed 20 Jun 2024
  3. 3 CMU Walls Corridor at Locker Rooms 11 Jun 2024
  4. 4 Exterior Precast Wall Paint 19 Jun 2024
  5. 5 Gym Roof and RTU Install 11 Jun 2024
  6. 6 Gym Slab-on-Grade 20 Jun 2024
  7. 7 Multi-Purpose Space Slab on Grade 20 Jun 2024
  8. 8 NW Facade of Program Space 11 Jun 2024
  9. 9 Running Track Railing and Slab 11 Jun 2024
  10. 10 SW Corner Facade of Program Space 11 Jun 2024

The structural Steel installation of the running track is complete.  The roof system over the program space is ongoing.  The roof system over the gym has begun.  2nd floor overhead MEPFP is ongoing.  2nd floor framing is complete.  2nd floor in-wall MEPFP rough-ins have begun. The 1st-floor concrete slab-on-grade within the program space has been poured.  The exterior framing is complete.  The exterior envelope air barrier installation is ongoing, and the exterior face brick installation has begun on the North side of the facility.  Interior masonry walls have been laid out and installation has begun. Underground electrical services have been roughed in. The project is scheduled to be completed in December 2024.  Currently, the project has experienced 33 days of lost work due to the weather.

Budget

The current approved Project budget including all construction and Owner costs is $20.181 Million.  The current estimate of the construction cost remains within budget at $17.9 Million.

Safety

Through May 2024 there have been no injuries and/or lost days due to accidents.

Submittals

The submittal process is ongoing.

RFIs

To date, there have been 104 RFIs issued, and 4 are currently open. There are no critical/priority RFIs at this time.

Project Achievements/Completed Milestones

  1. The last two precast panels for the gym have been installed.
  2. 100% of the underground electrical has been installed
  3. 100% of the running track steel has been installed.
  4. 100% of the 2nd floor framing has been installed.
  5. 100% of the 1st flr concrete slab-on-grade has been installed.
  6. 100% of the CMU partition walls in the gym have been installed.
  7. 100% of the exterior framing and sheeting has been installed.
  8. 80% of the 2nd-floor Overhead MEPFP rough-ins have been installed.
  9. 80% program space roof system has been installed.
  10. 80% of the exterior envelope air barrier has been installed.
  11. 50% of the 2nd-floor MEPFP in-wall rough-ins have been installed.
  12. 50% of the West/East Stairs has been installed.
  13. 30% of the Gym Overhead MEPFP has been installed.
  14. 30% of the 1st-floor Overhead MEPFP rough-ins have been installed.
  15. 15% of the exterior brick façade has been installed.
  16. Layout of the 1st-floor partition walls has begun.
  17. Approximately 15,867 hours have been worked to date, with 6,192 man-hours in May.

 Upcoming Milestones

  1. Complete install of Overhead MEPFPs on 1st & 2nd floor – Jun 2024
  2. Complete installation of Roof Systems – Jun 2024
  3. Complete install of 2nd flr in-wall MEPFP rough-ins – Jun 2024
  4. Complete installation of exterior masonry facade – Jun 2024
  5. Begin install of 1st flr framing – Jun 2024
  6. Begin install of 1st flr in-wall MEPFP rough-ins – Jun 2024
  7. Begin installation of interior masonry partition walls – Jun 2024
  8. Begin installing Alum Storefront/Curtainwall Systems – Jun 2024
  9. Install Concrete Slab-on-Grade (SOG) Gym – Jun 2024
  10. Continue installation of electrical service rough-ins – Jun 2024

Critical Action List

Temporary Power to the facility

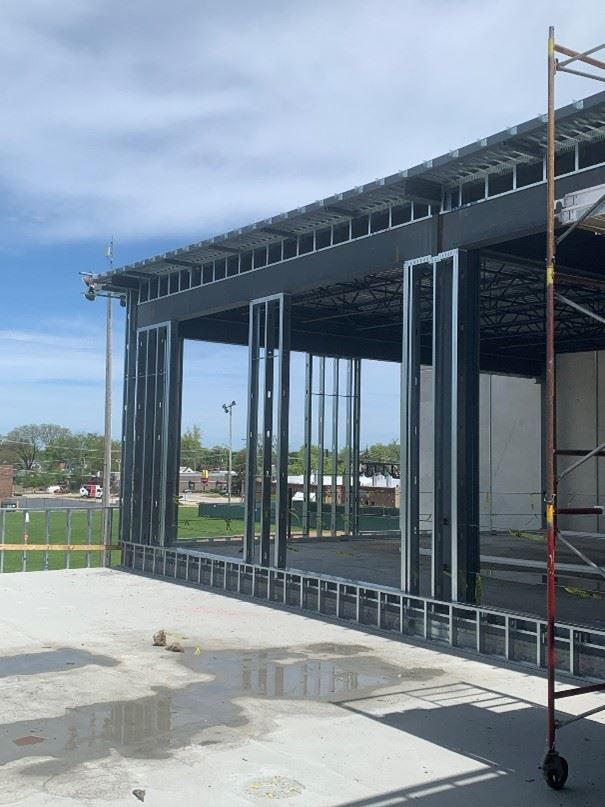

  1. 1 Ext Envelop Framing Admin Space Terrace 1 May 2024
  2. 2 Exterior Sheeting North Side Program Space 7 May 2024
  3. 3 Gym Storage Rm CMU Walls 21 May 2024
  4. 4 Install of Running Track Decking 23 May 2024
  5. 5 MEP Rough in 2nd Flr 1 MAy 2024
  6. 6 1st Flr Slab on Grade 24 May 2024
  7. 7 2nd Flr Overhead Duct Install 10 May 2024
  8. 8 2nd Flr Partition Wall Framing 21 May 2024
  9. 9 Air Barrier Brick Facade Install West Elevation 24 May 2024
  10. 10 Spray Foam Insulation Roof Terrace 15 May 2024
  11. 11 Underground Electrical Rough in 7 May 2024
  12. 12 Running Track Installation 16 May 2024
  13. 13 Roof Install On Program Space 8 May 2024
  14. 14 Pour Elevated Slabs in Gym 8 May 2024
  15. 15 May24_Picture1

April 24, 2024: Help us name the recreation center!

Picture7 #1

The survey is now closed as of May 12, 2024.

The Village of Villa Park is embarking on an exciting journey as construction is underway on the brand-new recreation center. As this endeavor continues, we want you to be a part of the process. The Village has now reached the point of choosing a name for the center. Our goal is to find a name that captures the spirit and essence of our community. Your input is crucial in determining the identity of the recreation center, so please take a moment to share your suggestions and thoughts on what the recreation center should be named. Let's shape the future together!

Structural Steel installation of the running track is ongoing.  The roof decking has been installed. The 2nd floor concrete topping in the program space has been poured. Underground plumbing has been completed and the stone base throughout the facility has been installed.  The rooftop HVAC units have been set.  Layout of the 2nd-floor partition walls is ongoing. Overhead MEPFP materials are being delivered, and installation has begun. The project is scheduled to be completed in December 2024.  Currently, the project has experienced 31 days of lost work due to the weather. The new electrical contractor, J. Hamilton Electric mobilized the last week of April to begin their underground installation.

Project Achievements/Completed Milestones

  1. 100% of the 2nd floor concrete topping has been installed.
  2. 100% of the underground plumbing has been installed.
  3. 100% roof decking has been installed.
  4. 100% of the precast, less two panels for gym access, have been installed.
  5. 100% of the stone base for the new concrete slab on grade has been installed.
  6. Approximately 40% of the running track steel has been installed.
  7. Approximately 60% of the exterior framing has been installed.
  8. Approximately 9,827 man-hours have been worked to date, with 2,232 man-hours in April.

Upcoming Milestones

  1. Complete installation of Running Track Steel – May 2024
  2. Complete framing of Building Enclosure – May 2024
  3. Begin to install 2nd Flr Interior Partition Framing – May 2024
  4. Begin installation of Underground Elec – May 2024
  5. Begin installation of Overhead MEPs
  6. Begin Sheeting and Air Barrier installation for the Building Enclosure – May 2024
  7. Install Roofing – May 2024
  8. Install Concrete Slab-on-Grade (SOG) Program Space – May 2024

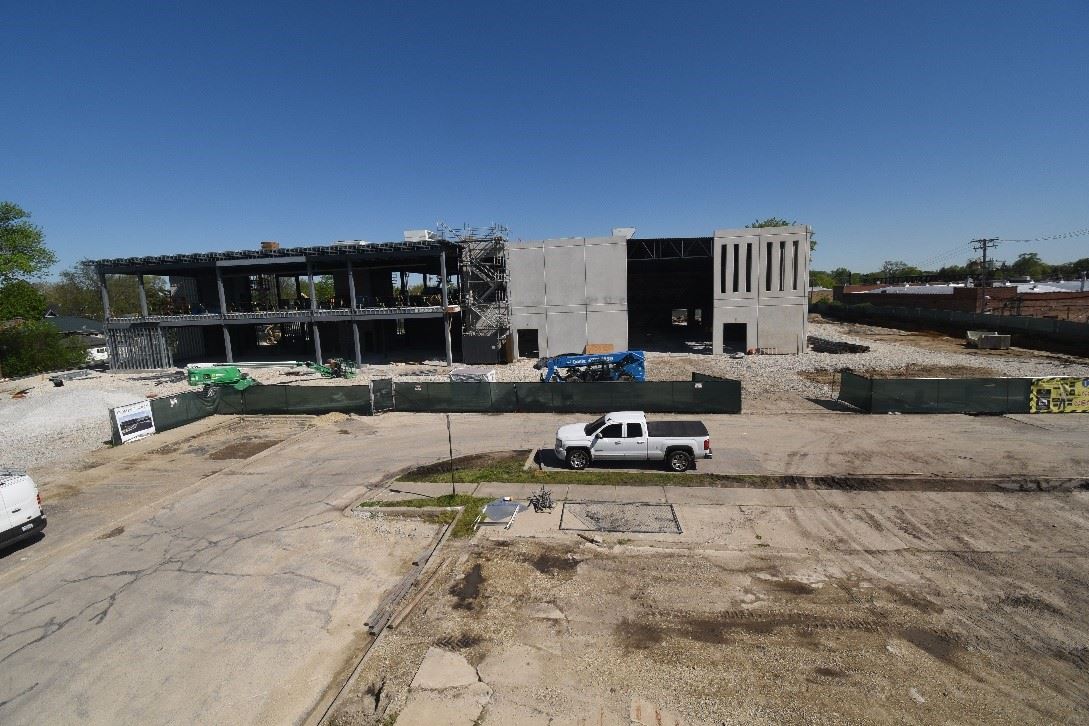

  1. 1 Rec Apr 24_1
  2. 2 Rec Apr 24_2
  3. 3 Rec Apr 24_3
  4. 4 Rec Apr 24_4
  5. 5 Rec Apr 24_5
  6. 6 Rec Apr 24_6
  7. 7 Rec Apr 24_7
  8. 8 Rec Apr 24_8
  9. 9 Rec Apr 24_9

April 8, 2024

Project Update: Structural Steel detailing in the Program space is ongoing.  Pre-cast hollow core floor planks for the second floor were installed.  Pre-cast wall panel installation is ongoing.  Long-span roof trusses in the Gym have been delivered and installed.  The project is scheduled to be completed in December 2024.  Currently, the project has experienced 28 days of lost work due to the weather.  Valley Electric, the building electrician, abruptly went out of business in March.  Working with the Village Attorney, and Valley’s bonding company, the Village is recommending an award to the 2nd bidder, J. Hamilton Electrical at the Board Meeting on Apr 8.  This will NOT significantly impact the project schedule.

Project Achievements/Completed Milestones

  1. 100% of the pre-cast hollow core planks have been set to date.
  2. 100% of the gym’s long-span trusses have been installed
  3. Approximately 95% of pre-cast wall panels have been erected to date
  4. Approximately 80% of the structural steel has been erected to date.
  5. Approximately 80% of the underground plumbing has been installed.
  6. Approximately 7,219 man hours have been worked to date, with 1,520 man hours in the month of March

Upcoming Milestones

  1. Steel Erection completion – Apr 2024
  2. Begin Exterior Envelope – Apr 2024
  3. Install Running Track Steel – Apr 2024
  4. Install Concrete Topping 2nd Flr Program Space – Apr 2024
  5. Begin Building Enclosure – Apr 2024
  6. Begin Roofing – Apr 2024
  7. Install Concrete Slab-on-Grade (SOG) Program Space – Apr 2024
  1. 1 Picture2
  2. 2 Picture3
  3. 3 Picture4
  4. 4 Picture5
  5. 5 Picture6
  6. 6 Picture7
  7. 7 Picture8
  8. 8 Picture9
  9. 9 Picture10

March 12, 2024

Project Update: Structural steel for the program space is being erected and pre-cast hollow core floor planks for the second floor are being installed.  The project is scheduled to be completed in December 2024.  Currently, the project has experienced 25 days of lost work due to weather.  Approximately 50% of the structural steel has been erected to date and 60% of the pre-cast hollow core planks.

Upcoming Milestones

  1. Steel Erection completion – Mar 2024
  2. Hollow Core Plank Install completion – Mar 2024
  3. Install Pre-Cast Wall Panels (Gym)  – Mar 2024
  4. Install Long Span Joists (Gym) – Mar 2024
  5. Begin Exterior Envelope – Mar 2024
  6. Install Running Track Steel – Mar/Apr 2024
  7. Install Concrete Topping 2nd Flr Program Space – Apr 2024
  8. Begin Building Enclosure – Apr 2024
  9. Begin Roofing – Apr 2024
  10. Install Concrete Slab-on-Grade (SOG) Program Space – Apr 2024

December 31, 2023

The new building pad is built to subgrade. The concrete foundation work is complete.  Site Utility work is substantially complete.  The masonry West Stairwell, Elevator Shaft, and shear walls are in progress.  Underground building plumbing and electrical are in progress. Structural masonry shear walls are approximately 75% complete and are scheduled to be completed in early January.  Steel is tentatively scheduled for delivery and installation in early January, with pre-cast hollow core planks to follow in mid-February. The project is scheduled to be completed in December 2024.  Currently, the project has experienced 9 days of lost work due to weather.

Upcoming Milestones

  1. Begin Steel Erection – Jan 2024
  2. Completion of Masonry Stair & Elevator Shaft Installation – Dec 2023
  3. Begin Hollow Core Plank Installation – Feb 2024
  4. Begin Exterior Envelope – Feb 2024
  5. Begin Pre-Cast Wall Panels (Gym)  – Mar 2024
  6. Begin Building Enclosure – Apr 2024

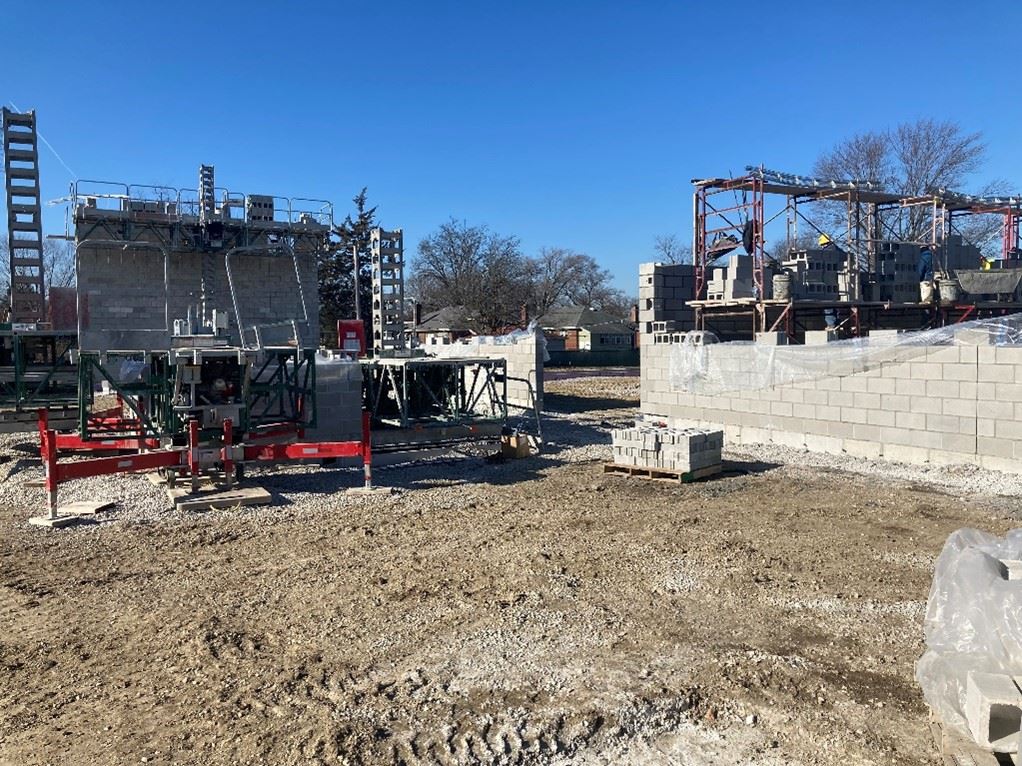

  1. 1 elevator shaft
  2. 2 NW Corner of Program spacing dec
  3. 3 west stair tower facing south dec
  4. 4 west stair tower

November 21, 2023

Permit received in mid-October, contractors are reviewing all permit review comments and incorporating them into the project.  Construction fence w/windscreen has been installed, and trades have mobilized with site work and foundation work beginning. Upcoming work to be completed:

  1. Begin Steel Erection – Dec 2023
  2. Begin Masonry Stair & Elevator Shaft Installation – Dec 2023
  3. Begin Hollow Core Plank Installation – Jan 2024
  4. Begin Exterior Envelope – Jan 2024
  5. Begin Pre-Cast Wall Panels (Gym)  – Feb 2024

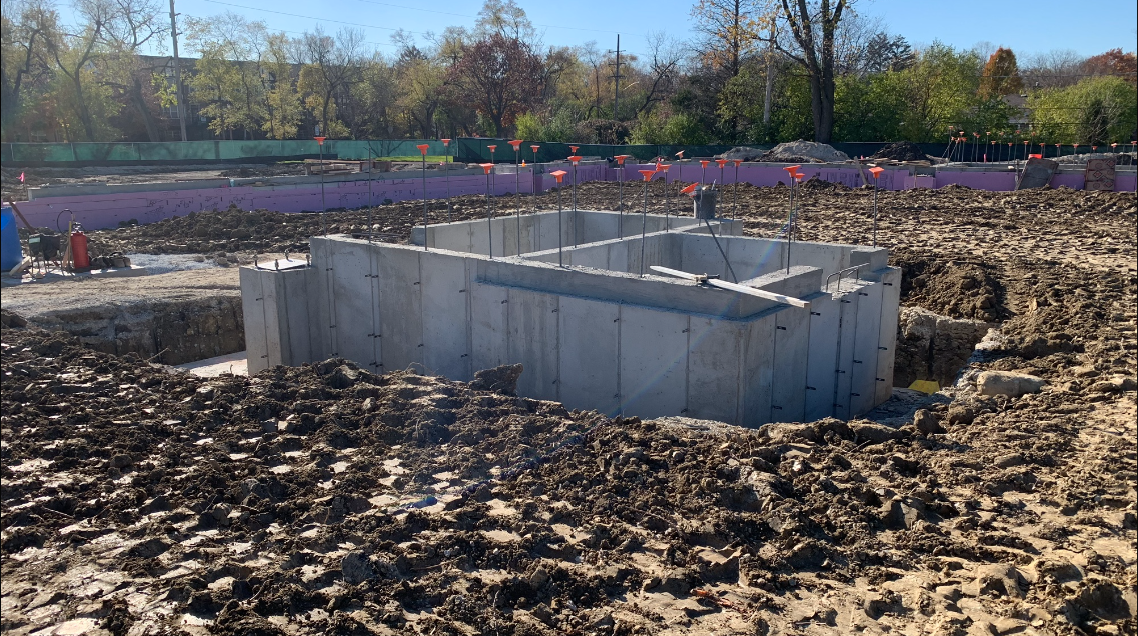

  1. 1 concrete framework con
  2. 2 recreation center ground level
  3. 3 wood frame work
  4. 4 concrete base with wood frame work
  5. 5 concrete framework
  6. 6 crane and leveled dirt

September 22, 2023

The Village of Villa Park would like to invite you to join us for the groundbreaking of the NEW Lions Park Recreation Center! The groundbreaking will take place at 320. E. Wildwood St, Villa Park, IL 60181 at 5:30 pm on Friday, September 29, 2023.

July 6, 2023

Preparations to take down the Community Recreation Building are being completed today, 7/6/2023.  The Community Recreation Building structure will be taken down and demolished starting tomorrow, 7/7/2023 at 7:00 am.

June 27, 2023

Demolition of the Community Recreation Building and Site will begin on Wednesday 6/28/2023.  Crews will begin with the removal of the playground and preparing the building to be taken down.  Preparing the building consists of the removal of the roofing material and other nonstructural materials, we expect the work to prepare the building to take 2-3 days.  We will provide more information as it becomes available and once the building structure is prepared to be taken down and demolished.

June 16, 2023

Demolition site security fencing will be installed on Friday, June 16th.  Permits are finalized and will be issued following the inspection of security fencing. Demolition is expected to begin the week of June 19th. As with all construction sites, the area will be inaccessible to the general public.

June 14, 2023

DEMOLITION OF THE COMMUNITY RECREATION BUILDING

The CRB building served our community well for many years, but as we say goodbye to this older facility and outdated playground, we say hello to a new state-of-the-art facility that will enhance our community. This recreation center will be a hub of activity, offering opportunities for fitness, leisure, and community engagement. The new recreation center will feature many modern amenities, including a full gymnasium, a fully equipped fitness center, multipurpose rooms, and even dedicated spaces for cooking classes.

The demolition of the CRB building will occur soon after Permits have been approved. As with all construction sites, the area will be inaccessible to the general public.

2021-2022 $10M Grant Information

In September 2021, the Village of Villa Park received notice that the community received a $10 million grant from the Department of Natural Resources- Build Illinois Bond Fund grant to be used towards costs associated with the construction of a Parks and Recreation Center.

grant info
